Township Road 570 – Range Road 230 to Range Road 224

Project Description

This project involves the reconstruction of (gravel) of 3.2 km of Township Road 570 between Range Road 230 and Range Road 224 (Opal Road)

Scope of Work

The scope of work includes widening the road cross section, reconstructing the existing road structure, grading improvements to ensure a uniform width, improving drainage, and reshaping the ditches/side slopes to acceptable standards.

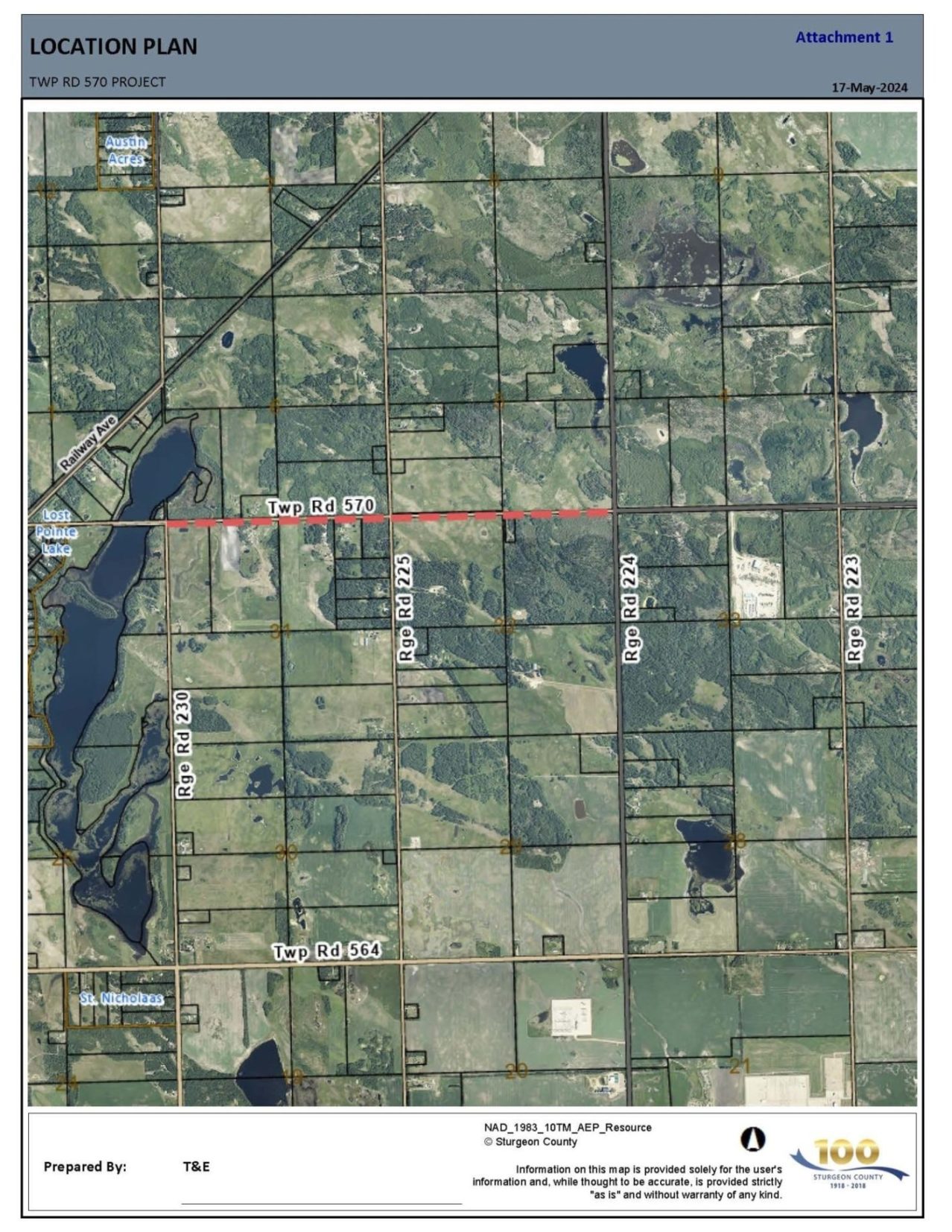

Map

Updates

  • February 12, 2025: Remaining work
    February 12, 2025

    In 2025, the stockpiled topsoil will be screened and hauled away.

    Sturgeon County is committed to completing and maintaining the landscaping within the project area. Grass seeding will be done by Sturgeon County Agriculture Services as a trial plot for different seed mixes and methods.

    Our team will be monitoring the site, addressing weeds, and ensuring healthy grass growth.

    Residents may notice ongoing maintenance as we work to establish the landscaping. We appreciate your patience and cooperation.

  • November 8, 2024: Work continues

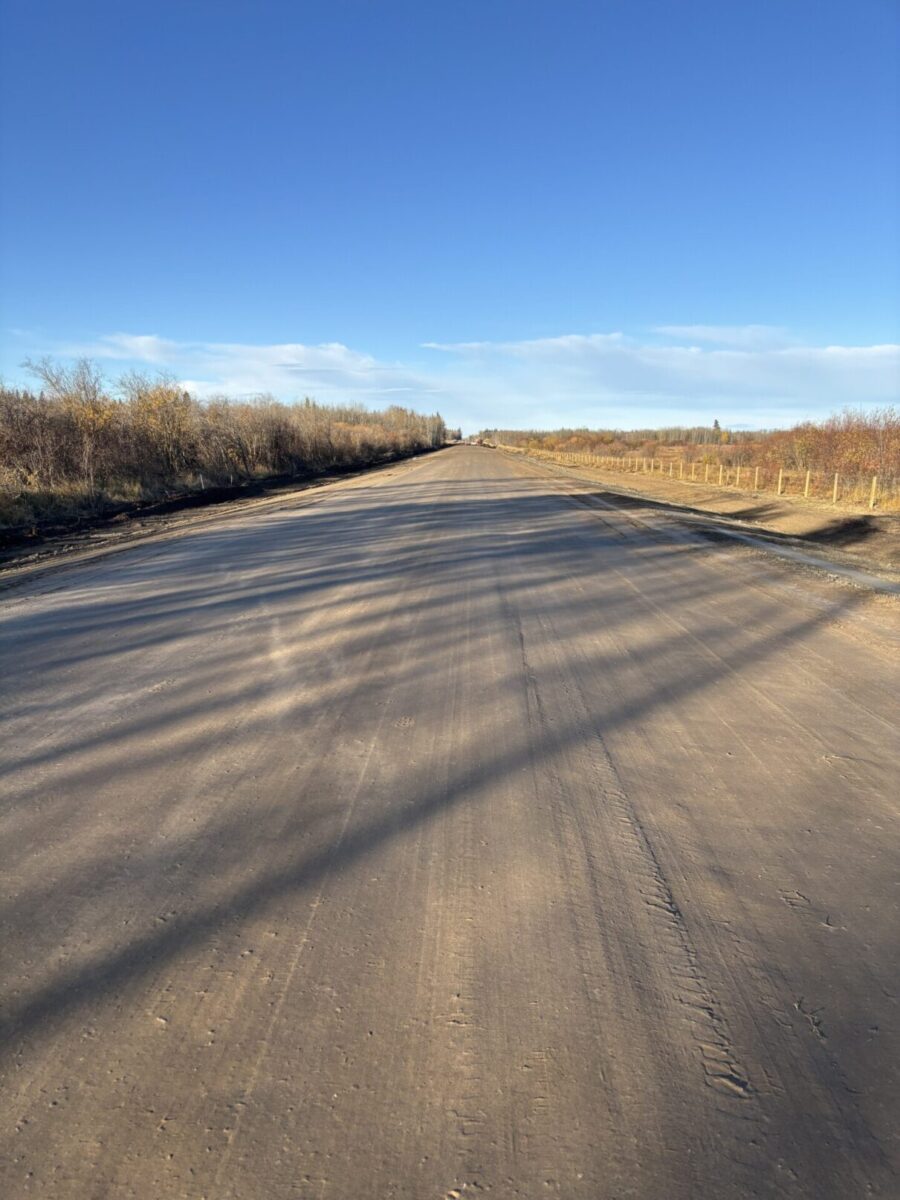

    November 8, 2024

    Work will continue as long as the weather conditions allow.

  • November 1, 2024: Work continues
    November 1, 2024

    While there are no specific updates this week, we will keep you informed as this project progresses.

  • October 25, 2024: Work continues
    October 25, 2024

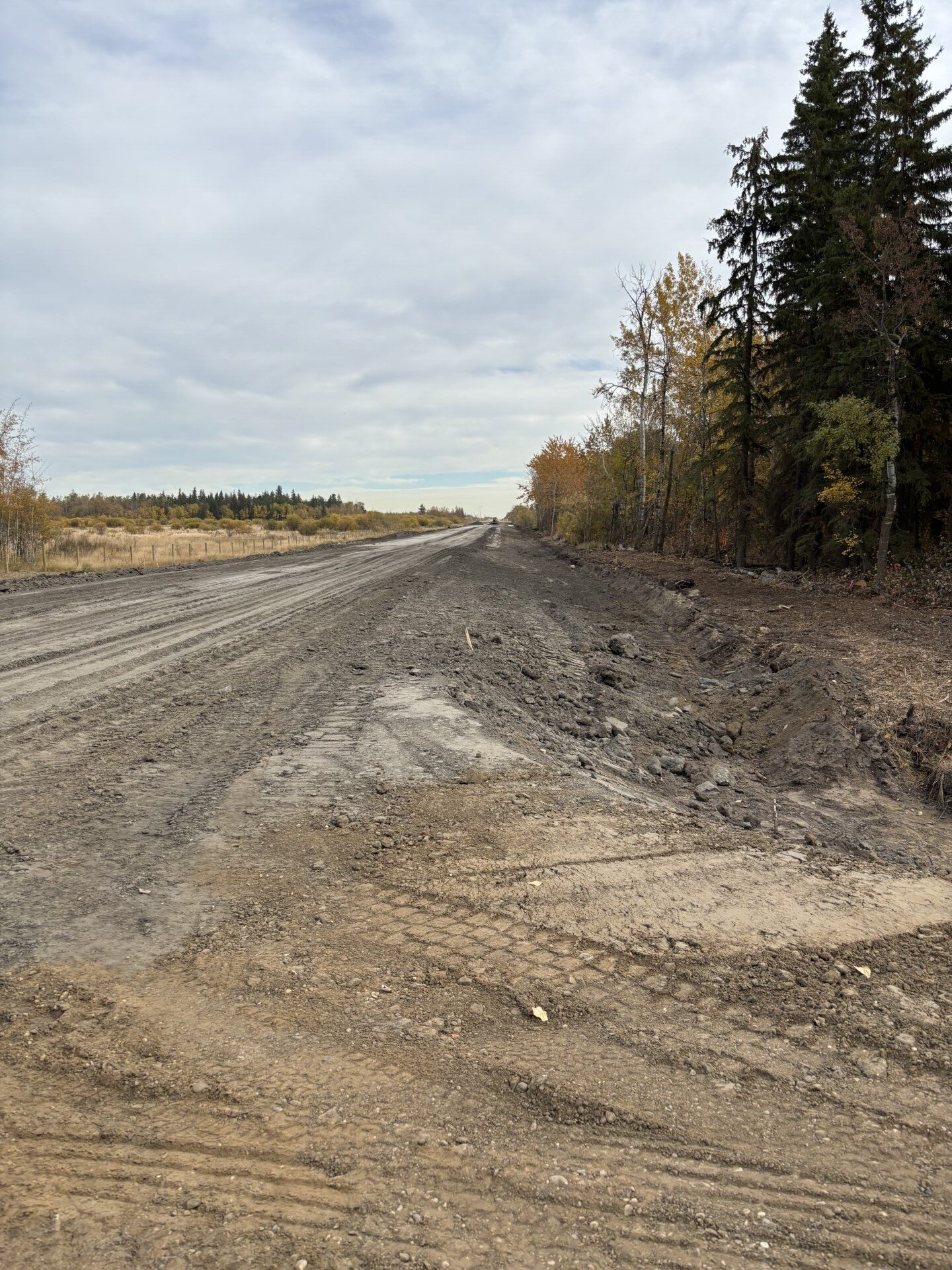

    Construction crews are working on this project. While we don’t have a specific update this week, we will keep you informed as this project progresses.

  • October 18, 2024: Work continues
    October 18, 2024

    Construction crews are working on this project. While there are no specific updates this week, we will keep you informed as these projects progress.

  • October 11, 2024: Lane open
    October 11, 2024

    There is one lane of traffic open. Drive safely through the area.

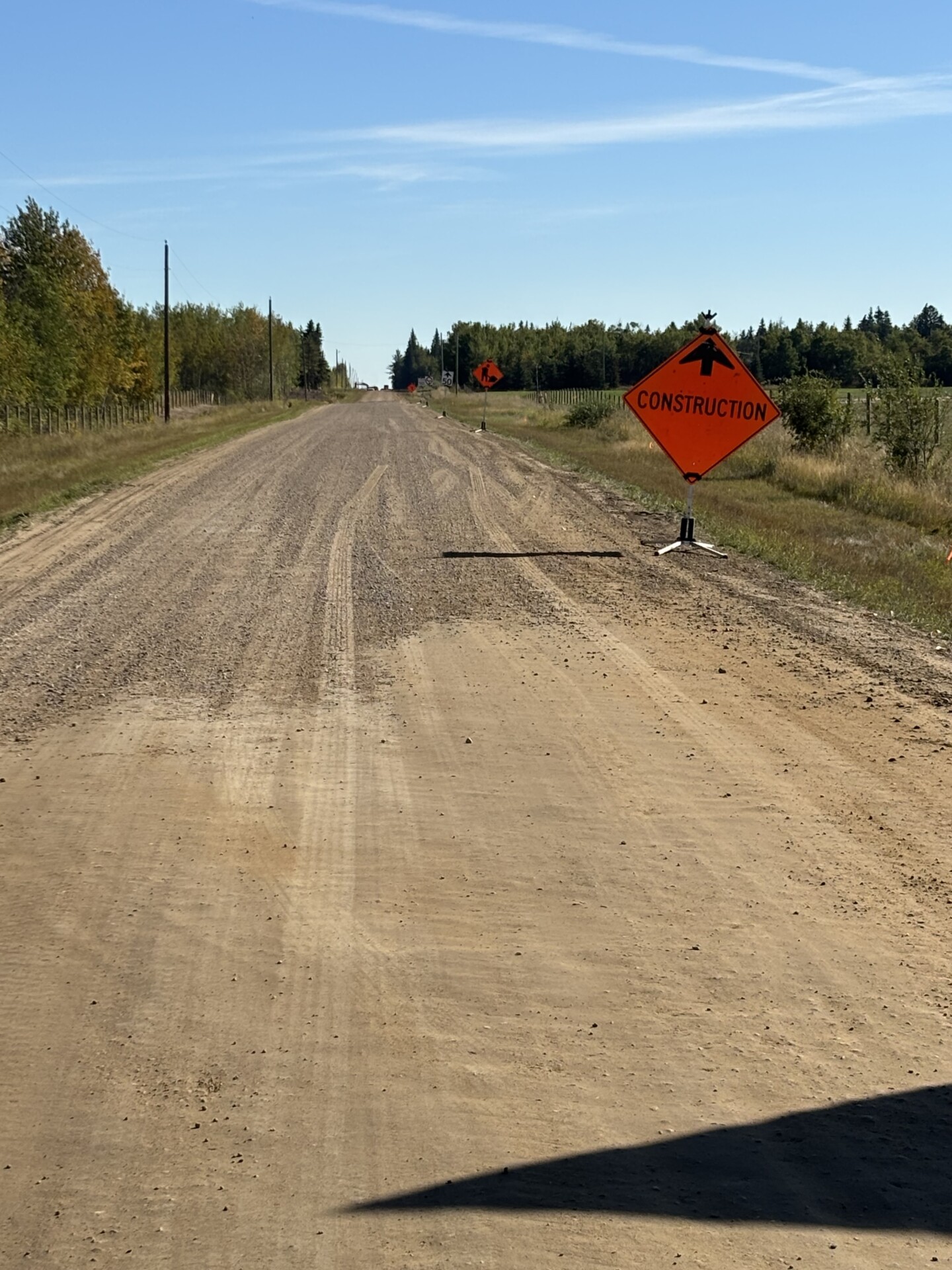

  • September 24, 2024: Project underway
    September 24, 2024

    Clearing and fencing are done, construction crews are now installing the culverts. One lane is open to traffic.

  • August 16, 2024: Start date
    August 16, 2024

    This project is expected to start September 1, 2024, weather permitting.

  • August 6, 2024: One lane road closure
    August 6, 2024

    One lane will be closed to traffic on August 26, 2024 to accommodate construction. No detour is requred.

  • July 19, 2024: Expected start date
    July 19, 2024

    This project is expected to start in mid-August.

  • May 28, 2024: Contract Awarded
    May 28, 2024

    County Council has awarded the contract for this project.

  • March 6, 2024: Project page created
    March 6, 2024

Newsletter

Subscribe for direct news and project updates to your inbox.

Connect

A fire advisory is in effect for Sturgeon County due to high temperatures and lack of precipitation.

Sturgeon County offices will be close Friday, April 18 and Monday, April 21 for the Easter weekend. Offices will re-open for regular business hours on Tuesday, April 22 from 8:30AM - 4:30PM.

Scroll to Top
